How we document work

Every project starts with a survey. Every survey produces a written record.

Before a method is specified, we identify the material, the soiling type, the condition of the pointing, and anything that suggests the building has been treated before. That diagnostic process produces a written specification. The before photographs are taken at the same time.

After works, we document the result in the same conditions where possible. The before and after you see here are not staged. The before is how the building looked when we arrived. The after is how it looked when the scaffolding came down.

Material

Every substrate identified before any method is chosen. Portland stone, London stock brick, limestone, sandstone, terracotta — different materials, different approaches.

Method

DOFF steam cleaning, TORC vortex aggregate, lime repointing, stone consolidation, paint removal. The method follows from the substrate — never the other way around.

Trial panel

A representative test area is cleaned first, left to dry, and assessed before full works proceed. On listed buildings this is documented and submitted to the Conservation Officer.

Result

The goal is invisible restoration. No trace of the method on the surface. The stone looks like stone, the brick looks like brick, and the building looks like itself.

Before After
Portland Stone • DOFF Steam Cleaning

Ornate Stone Frieze

City of London • Grade II Listed

A heavily soiled Portland stone frieze with carved circular medallions and cresting, running at second-floor level on a Victorian commercial building in the City. Decades of atmospheric soot had reduced the carved detail to a near-uniform black. The stone beneath was intact.

The soiling was general atmospheric particulate — carbon deposits from decades of combustion — sitting on a stable sulphate layer. DOFF at 150°C, calibrated through a 1m² trial panel and pre-approved by the City of London Conservation Officer. Full facade clean over four days from hanging scaffold.

The result restored the depth and precision of the carved detail. Arrises that had been invisible under the soiling layer were visible again within hours of drying.

MethodDOFF 150°C
MaterialPortland Stone
Duration4 days
View full case study
Portland Stone • DOFF + TORC

Baroque Broken Pediment

Westminster • Listed Building

A baroque broken pediment with acanthus scroll ornament and dentil cornice, forming the centrepiece of a late seventeenth-century Portland stone facade. The soiling was two-layered: general atmospheric deposit on the exposed surfaces, and dense sulphate crust in the sheltered recesses of the ornament where rainwater could not reach.

DOFF addressed the atmospheric soiling on the open surfaces. TORC vortex cleaning, using a 60-micron calcium carbonate aggregate, removed the sulphate crust from the sheltered detail without abrading the carved surface. The two methods were used in sequence, not simultaneously. Westminster Conservation Officer pre-approved the full method statement before works commenced.

Selective lime mortar repair to a damaged section of the acanthus scroll was carried out on completion. The repair was matched to the adjacent stone by colour assessment and is not visible at normal viewing distance.

MethodDOFF + TORC
MaterialPortland Stone
Duration6 days
View full case study
Before After
Before After
Portland Stone • DOFF + Lime Repointing

Chimney Stack Restoration

Central London • Period Building

A Portland stone chimney stack showing extensive biological growth — algae, lichen, and moss colonisation — combined with atmospheric soiling and defective pointing. The stack had been repointed with hard cement at some point in the mid-twentieth century. The cement had cracked and was allowing water ingress into the stack itself.

DOFF at 150°C removed the biological growth and soiling. Following cleaning and drying, the defective cement pointing was removed using an oscillating multi-tool and replaced with a feebly hydraulic lime mortar (NHL 2) matched to the original. The corbel detail at the base of the stack was cleaned with particular care to preserve the carved profile.

Works were carried out from a mobile elevated work platform over two days. No scaffold was required. The stack is now watertight and the biological colonisation has been removed without any abrasive contact with the stone surface.

MethodDOFF + Lime
MaterialPortland Stone
Duration2 days
View full case study
Portland Stone • DOFF + Stone Consolidation

Ionic Capital, Column Shaft & Base

City of London • Grade I Listed

A free-standing Portland stone Ionic column showing soiling across the shaft and biological growth on the capital and base. The column sits in an exposed position and had been subject to repeat wet-dry cycling over many decades, resulting in some surface friability on the north-facing flank of the shaft.

DOFF cleaning was carried out first, at reduced temperature to account for the friable surface condition. Following cleaning and thorough drying, a consolidant was applied to the affected section of shaft: a compatible lime-based consolidant, applied by brush in multiple thin coats and allowed to carbonate between applications. The consolidant does not change the appearance of the stone and does not form a film on the surface.

Historic England was consulted on the consolidant specification given the Grade I listing. The full method statement and product data sheets were submitted with the Listed Building Consent application.

MethodDOFF + Consolidant
MaterialPortland Stone
ListedGrade I
View full case study

Ionic capital, cleaned Portland stone — City of London

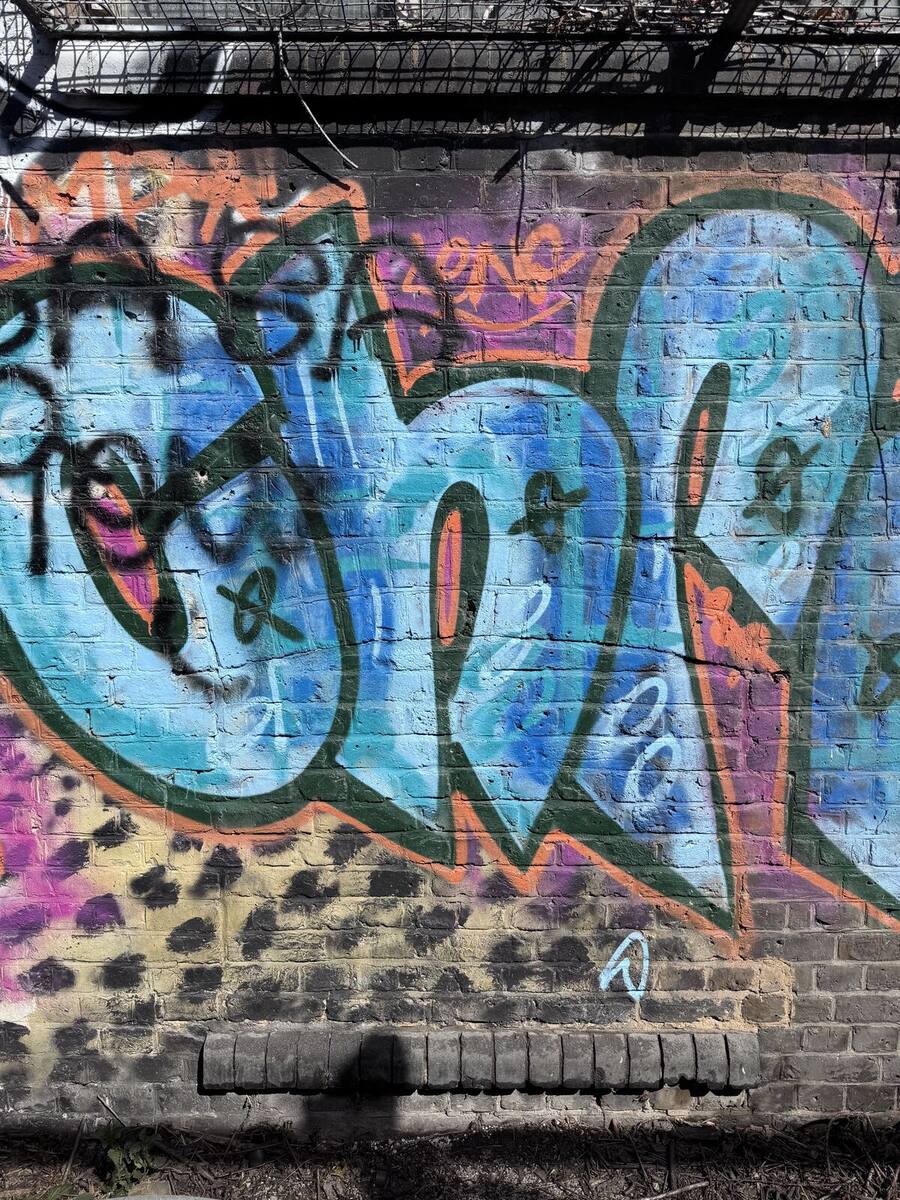

Aerosol graffiti covering London stock brick wall before removal Before

Cleaned London stock brick wall after graffiti removal After

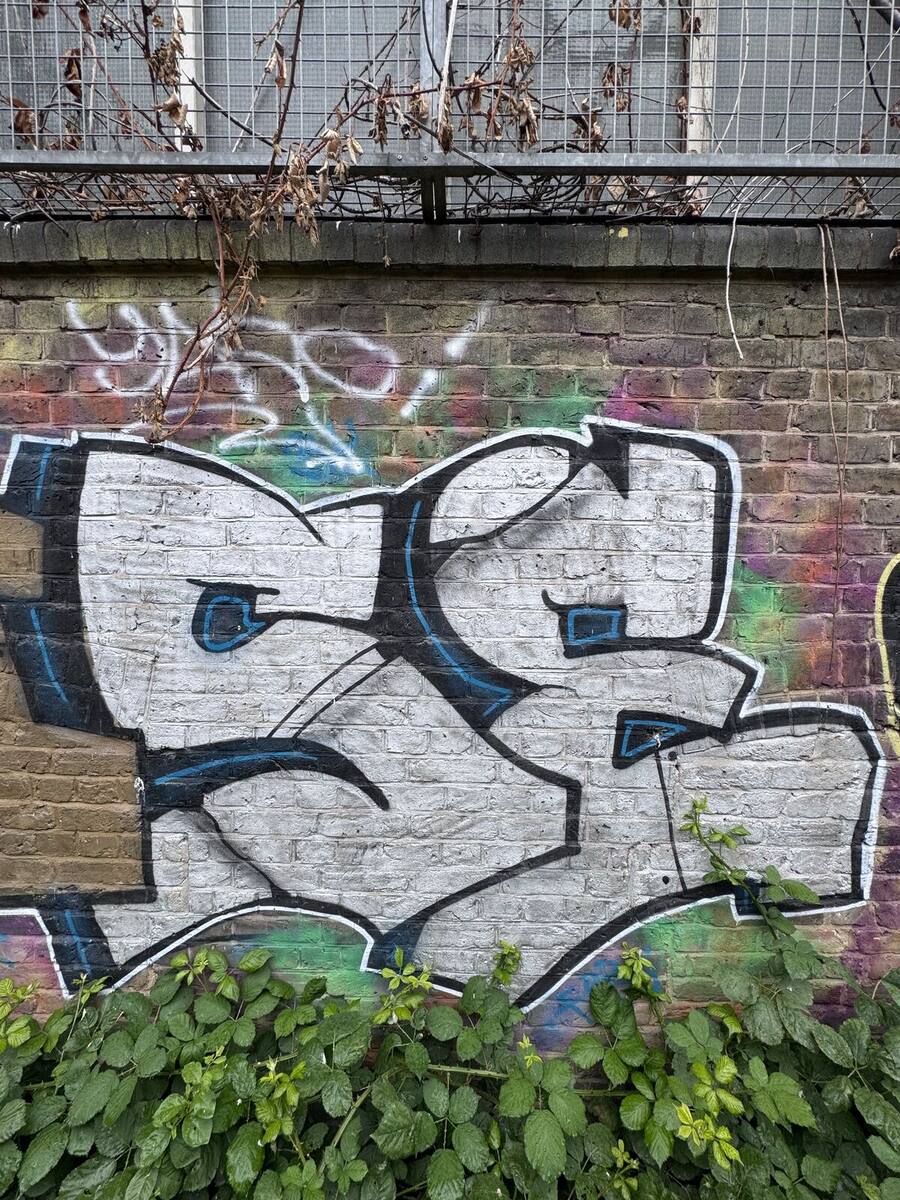

Spray paint tags on brick wall prior to paint removal Before

London stock brick cleaned and repointed with lime mortar after paint removal After

Graffiti removal and repointing, London stock brick boundary wall

London Stock Brick • Paint Removal

Graffiti Removal, Brick Boundary Wall

London • Period Boundary Wall

A long run of nineteenth-century London stock brick boundary wall carrying multiple layers of aerosol graffiti, alongside general soiling and biological growth at the coping. London stock is a soft, porous brick, and aerosol paint penetrates the surface layer — the wrong removal method takes the brick face with it.

The paint was removed with a targeted chemical poultice, applied in stages and given a full dwell period before removal, followed by a low-pressure DOFF steam rinse to clear residue and the biological growth. No abrasive blasting and no caustic stripping at any stage. Sections of eroded and cement-patched pointing were cut out and repointed in a lime mortar matched to the original joint colour and profile.

The wall now reads as it was built: the varied yellows, purples, and browns of the original stock brick are visible again, including the gauged arch details that had disappeared entirely under the paint.

MethodPoultice + DOFF
MaterialLondon Stock Brick
FinishLime Repointing
View full case study
